Projects

A project is a job you have won and are now delivering. It is usually started from an accepted quotation, and brings together everything about the job: stages, tasks, designs, purchases, site reports, payments and the profit so far.

The project page has tabs for each part. The costing tab compares what the job is costing with what it was sold for, so you know if it is making money while there is still time to act.

The screens

All projects

Every job you are running, with progress and money at a glance.

  1. The cards: active projects (and how many are completed), the value contracted across them, how many have a target date this month, and how many are past their target.
  2. By stage: how many projects are in Planning, Design, Procurement, Execution, Inspection and Handover. Tap a stage to see only those.
  3. The list: each project with its code, customer, stage, contract value and target date (in colour when it has passed). Search by project, code or customer.
  4. New project at the top right starts one; most projects are started from an accepted quotation instead.
  5. Your projects are also listed under All projects in the menu, so you can jump to one from anywhere.
Where in the menu
Projects > All projects
Who can open it
Company Admin, Project Manager, Employee, Viewer
Plan
Every plan

Read about this screen: How do I start a project? · What are the project stages and how do I move a project along? · Why can't I see a project, or its costing?

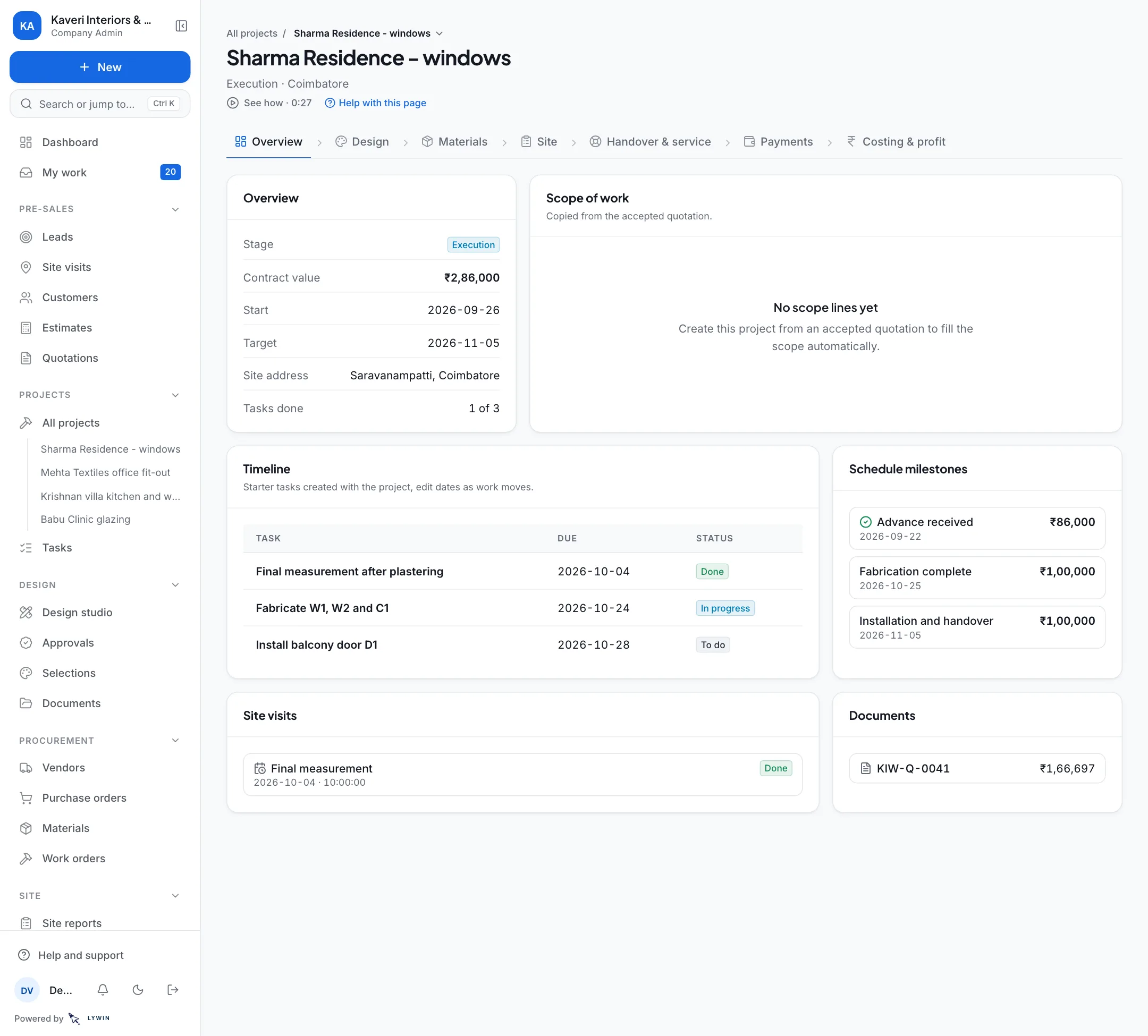

One project

Everything about one job in one place.

  1. The tabs across the top follow the job: Overview, Design, Materials, Site, Handover & service, Payments, and Costing & profit.
  2. Overview: the stage, contract value, start and target dates, site address and how many tasks are done.
  3. Scope of work: the lines copied from the accepted quotation.
  4. Timeline: the project's tasks with due dates and status. Schedule milestones: the payment stages, with a tick on those received.
  5. Site visits and Documents for this project, at the bottom.

Read about this screen: How do I bill a project in parts: advance, stages and final bill? · What are running bills and how do I make one? · What is on a project's page? · What are the project stages and how do I move a project along? · How do I see the profit on a project? · How does the UPVC offcut wastage estimate work?

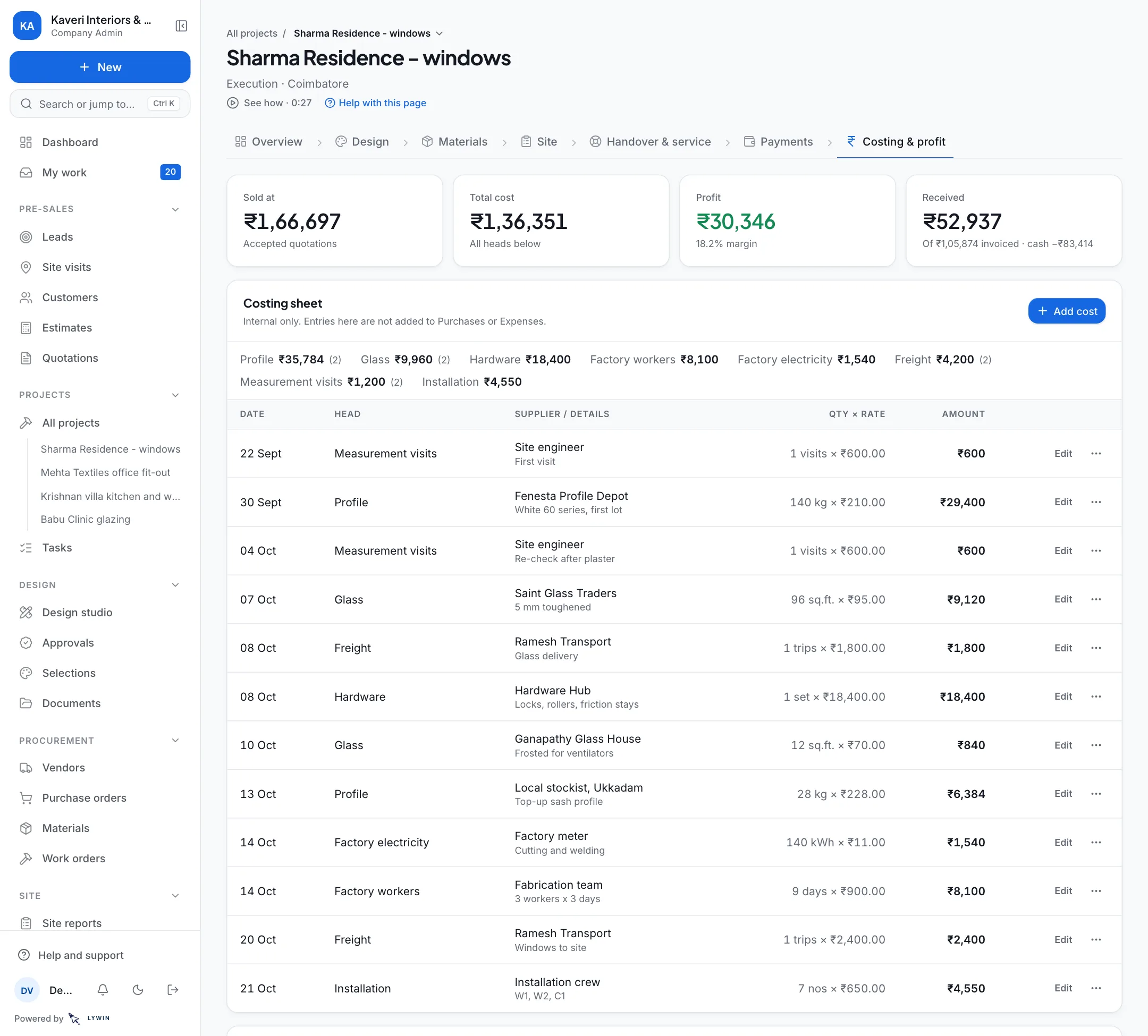

Project costing and profit

What the job is costing against what it was sold for.

  1. The cards: what the job was sold at, its total cost so far, the profit and margin, and how much has been received against what was invoiced.
  2. Costing sheet: every cost of the job, totalled by head (profile, glass, hardware, workers, freight, installation and so on).
  3. Each line: date, head, supplier and details, quantity times rate, and amount. Edit or remove it from the end of the row.
  4. Add cost puts in a cost that is not a purchase order or an expense. Entries here stay on this sheet only.

Read about this screen: How do I bill a project in parts: advance, stages and final bill? · What are running bills and how do I make one? · What is on a project's page? · What are the project stages and how do I move a project along? · How do I see the profit on a project? · How does the UPVC offcut wastage estimate work?

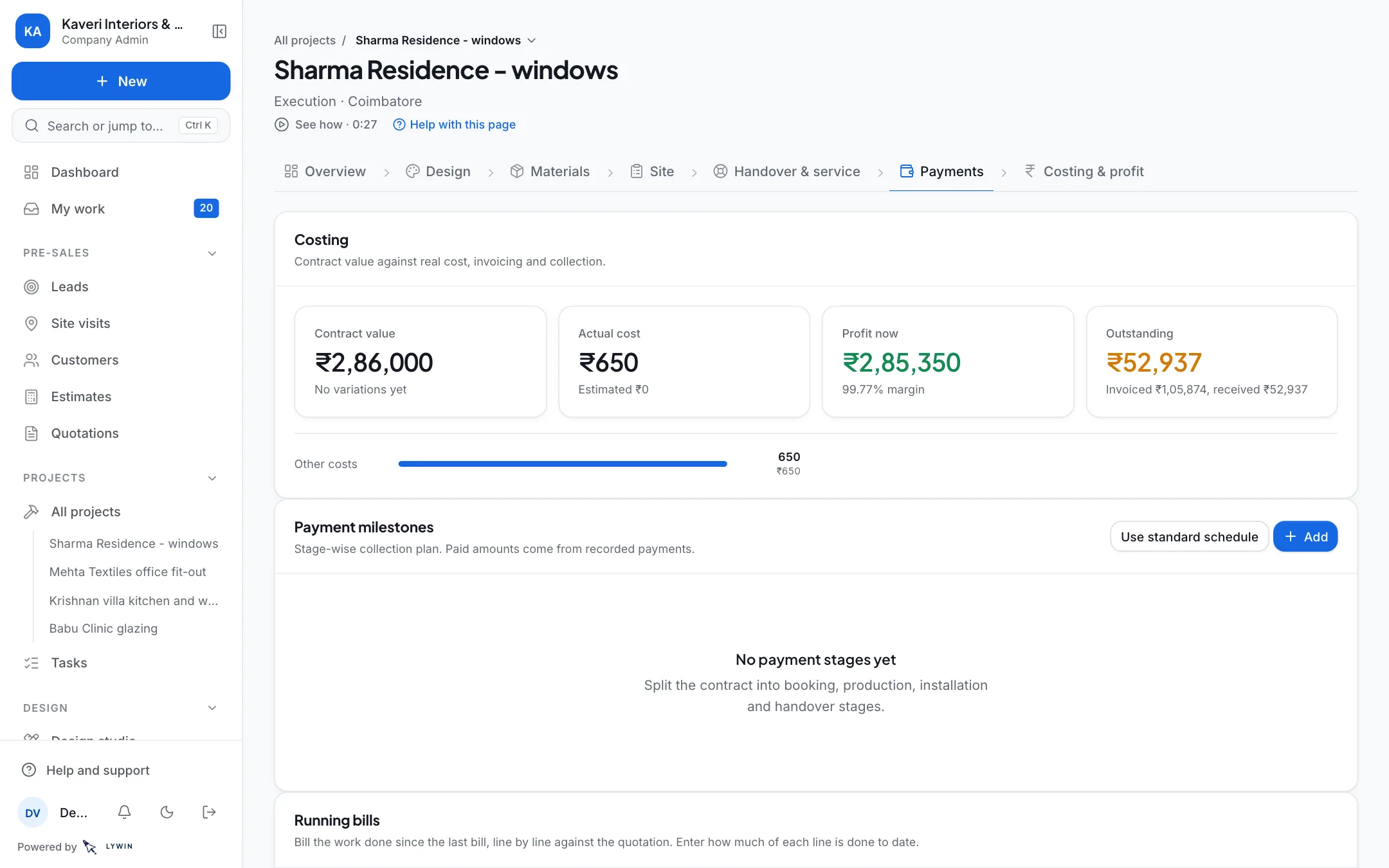

Project payments

The payment plan, what was billed and what came in.

  1. Costing: contract value, actual cost, profit now and what is still outstanding, with invoiced and received.
  2. Payment milestones: the stage-wise plan for collecting the money (booking, production, installation, handover). Use standard schedule fills a usual plan; Add puts in your own stage.
  3. Running bills (further down): bill the work done since the last bill, line by line against the quotation.

Read about this screen: How do I bill a project in parts: advance, stages and final bill? · What are running bills and how do I make one? · What is on a project's page? · What are the project stages and how do I move a project along? · How do I see the profit on a project? · How does the UPVC offcut wastage estimate work?

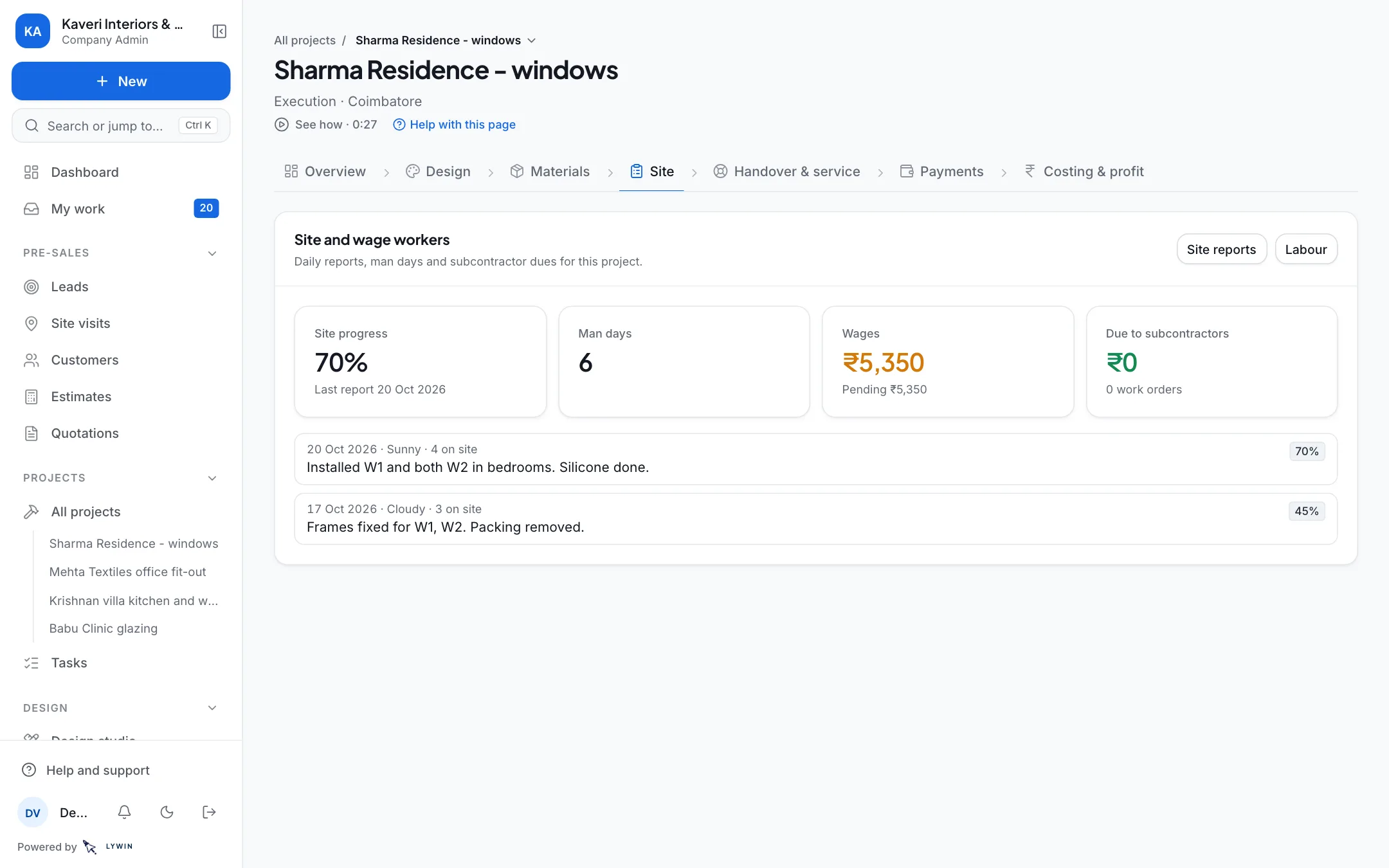

Project site work

Daily reports, photos and workers for this job.

  1. Site progress from the last daily report, man days worked, wages (and how much is still to be paid) and what is due to subcontractors.
  2. The daily reports for this project, newest first, with the weather, how many were on site, what was done and the progress.
  3. Site reports and Labour at the top right open those pages for this project.

Read about this screen: How do I bill a project in parts: advance, stages and final bill? · What are running bills and how do I make one? · What is on a project's page? · What are the project stages and how do I move a project along? · How do I see the profit on a project? · How does the UPVC offcut wastage estimate work?

How to

How to

How do I start a project?

Best from an accepted quotation: press Create project on it, and the scope, tasks, milestones, payment stages and a measurement visit are made for you. Or press New project on All projects.

Where in the menu
Projects > All projects
Who can open it
Company Admin, Project Manager, Employee, Viewer
Plan
Every plan
Where in the menu
Pre-sales > Quotations
Who can open it
Company Admin, Sales, Project Manager, Accounts, Viewer
Plan
Every plan

On screen: All projects Making a quotation One quotation

From an accepted quotation (recommended)

  1. Open the quotation. If the customer has not accepted on the link, press Mark accepted.
  2. Press Create project.

You get the scope of work copied from the quotation (the chosen version only, if there was a choice), starter tasks and stage milestones for the kind of work, payment milestones from the quotation's payment schedule, and a measurement visit. The project's contract value is the quotation total.

By hand

Open All projects and press New project. Fill in the name, customer, stage, contract value, internal budget, dates, project manager and site address. Add tasks, milestones and visits yourself afterwards.

How to · For Company Admin, Accounts

How do I see the profit on a project?

Open the project's Costing & profit. Add costs as they happen (profile, glass, hardware, factory, freight, installation and so on); linked purchase orders and expenses are counted too. It shows sold at, received, total cost and profit.

Where in the menu
Projects > All projects
Who can open it
Company Admin, Project Manager, Employee, Viewer
Plan
Every plan

On screen: One project Project costing and profit Project payments Project site work

  1. Open the project and choose Costing & profit on the stage bar.
  2. Press Add cost for each cost as it happens. Choose the head (profile, glass, hardware, factory labour, electricity, freight, measurement, installation, or name your own like "Scaffolding"), and type the amount, or quantity x rate. Several entries per head are fine, for example two glass suppliers.
  3. Already recorded elsewhere lists purchase orders and expenses linked to this project. They are counted, never copied; untick one to leave it out of the profit.

The top shows Sold at, Received, Total cost and Profit.

Entries on the costing sheet are internal only; they are not added to Purchases or Expenses. Only company admins and accounts see this page. Reports > Project profitability gives the same for every project in a period.

How to

How do I plan stage-wise payments for a project?

On the project's Payments tab, Payment milestones split the contract into stages with a percentage or amount and due date. Paid amounts come from recorded payments. Use standard schedule fills a usual split.

Where in the menu
Projects > All projects
Who can open it
Company Admin, Project Manager, Employee, Viewer
Plan
Every plan

On screen: One project Project costing and profit Project payments Project site work

  1. Open the project > Payments.
  2. Under Payment milestones, press Add payment milestone for each stage (booking, production, installation, handover). Give a percent of contract or an amount, and a due date.
  3. Or press Use standard schedule for a usual split.

Projects made from a quotation with a payment schedule already have these. What is paid against each stage comes from payments recorded on the project's invoices. The client sees the payment schedule on their project link.

Set a contract value on the project first; without one, percentages cannot be worked out.

How to

The client wants extra work. How do I add it to the project?

Record it as a change order on the project's Payments tab: what is changing, why, the extra amount, your extra cost and extra days. Approving it raises the project value.

Where in the menu
Projects > All projects
Who can open it
Company Admin, Project Manager, Employee, Viewer
Plan
Every plan

On screen: One project Project costing and profit Project payments Project site work

  1. Open the project > Payments > Change orders.
  2. Press Add change order: what is changing, the reason, the extra amount to charge, the extra cost to us, tax % and extra days.
  3. It does not change the project value until you press Approve (once the client agrees). Reject keeps it on record without charging.

An approved change order adds to the contract value and the profit figures. Bill it with an invoice like any other part of the job.

How to

How do I plan the material a site needs?

On the project's Materials tab add each material with the quantity needed. It shows what is ordered, received and on site, and what is still to order; raise purchase orders against the shortfall.

Where in the menu
Projects > All projects
Who can open it
Company Admin, Project Manager, Employee, Viewer
Plan
Every plan
Where in the menu
Procurement > Materials
Who can open it
Company Admin, Project Manager, Accounts, Viewer
Plan
Needs Vendors, purchase orders and materials
Where in the menu
Procurement > Purchase orders
Who can open it
Company Admin, Project Manager, Accounts, Viewer
Plan
Needs Vendors, purchase orders and materials

On screen: One project Project costing and profit Project payments Project site work

  1. Open the project > Materials.
  2. Press Add material to plan, pick from your materials list (or type one) and the quantity needed.
  3. The plan shows for each: Ordered, Received, On site and To order. Cards show the ordered value, open orders, what you owe vendors and how many items are short of plan.
  4. Raise purchase orders for what is short. Deliveries recorded on the orders update the plan.

Read next

How to

How do I record snags and hand over a project?

On Handover & service, add snags room by room on the walk-through. When they are cleared, press Hand over the project, enter who received it and a note.

Where in the menu
Projects > All projects
Who can open it
Company Admin, Project Manager, Employee, Viewer
Plan
Every plan

On screen: One project Project costing and profit Project payments Project site work

  1. Open the project > Handover & service.
  2. On the walk-through, press Add snag for each thing to fix: the room and what needs fixing (for example "shutter gap on tall unit").
  3. Mark snags done as they are fixed.
  4. When the list is clear, press Hand over the project. Enter Handed over to (the client's name) and a note (keys and warranty cards given), then Record handover.

After handover, complaints go in as service tickets and warranties are tracked on the same tab.

Good to know

Explained

What is on a project's page?

A stage bar across the top opens each part of the job: Overview, Design, Materials, Site, Handover & service, Payments, and Costing & profit (admins and accounts only).

Where in the menu
Projects > All projects
Who can open it
Company Admin, Project Manager, Employee, Viewer
Plan
Every plan

On screen: One project Project costing and profit Project payments Project site work

  • Overview: stage, contract value, start and target dates, site address, tasks done, the scope copied from the quotation, the timeline of tasks, schedule milestones, site visits and documents.
  • Design: drawings and views sent for client sign-off, material selections and documents for this project.
  • Materials: what the site needs, what is on order, what has arrived and what is short.
  • Site: daily site reports, man-days, wages and money due to subcontractors (and cameras, if you use them).
  • Handover & service: the snag list, the handover record, complaints after handover, warranties and the client's private project link.
  • Payments: contract value against cost, invoicing and collection; payment milestones; change orders; running bills.
  • Costing & profit: the internal costing sheet and the profit left. Only company admins and accounts see it.

Use Switch project at the top to jump to another project without going back to the list. Some parts need a plan feature; a locked one says which.

Explained

What are the project stages and how do I move a project along?

Planning, Design, Procurement, Execution, Inspection, Handover, Completed, plus On Hold and Cancelled. Edit the project to change its stage.

Where in the menu
Projects > All projects
Who can open it
Company Admin, Project Manager, Employee, Viewer
Plan
Every plan

On screen: All projects One project Project costing and profit Project payments Project site work

  • Planning: just started, measurements and scope being finalised.
  • Design: drawings and selections with the client.
  • Procurement: ordering material.
  • Execution: work on site.
  • Inspection: checking and snagging.
  • Handover: handing over to the client.
  • Completed: done. On Hold and Cancelled for paused or dropped jobs.

On All projects, press the pencil on the project and change Stage; set Completed on when it finishes. The By stage panel counts projects at each stage; tap one to filter. Completed and cancelled projects drop out of the active counts and the sidebar's project list. The person in charge is told when their project changes stage.

Explained

How does the UPVC offcut wastage estimate work?

From the window drawings, Inbecto works out the profile bars needed and the offcut left, by weight. Set your bar length, cut allowance and profile weights; record scrap you sell.

Where in the menu
Projects > All projects
Who can open it
Company Admin, Project Manager, Employee, Viewer
Plan
Every plan

On screen: One project Project costing and profit Project payments Project site work

On Costing & profit, UPVC offcut wastage (estimate) uses the windows on the project to estimate how many profile bars are cut and how much is left as offcut, by weight.

  • Bars and profile weights: set the bar length (mm), the allowance per cut (mm), the scrap rate (₹/kg) and each profile's weight. Check them against your profile supplier's catalogue. They apply to every project's estimate.
  • Record scrap sold notes money you got back for offcuts.

It is an estimate from the drawings, not a cutting list.

When something goes wrong

Fixing a problem

Why can't I see a project, or its costing?

Projects are open to admins, project managers, accounts, viewers and the employee role. Costing & profit is only for company admins and accounts. Sales does not see projects unless given access.

Where in the menu
Projects > All projects
Who can open it
Company Admin, Project Manager, Employee, Viewer
Plan
Every plan
Where in the menu
Setup > Team
Who can open it
Company Admin, Viewer
Plan
Every plan

On screen: All projects One project Project costing and profit Project payments Project site work

  • No Projects in the menu: your role does not open it (Sales, for example). Ask your company administrator to give you access on Team > Access.
  • Costing & profit missing on the stage bar: it is only for company admins and accounts.
  • A locked part of the project (Design, Materials, Site, Handover, Costing) belongs to a plan feature your package does not include. It says so when opened.
  • Completed or cancelled projects are not in the sidebar list; find them on All projects by changing the stage filter.
